Quick answer

What is a mall work permit?

A mall work permit is the written approval a tenant gets from mall management before carrying out work in their store, bringing in contractors or moving materials in or out. It sets out what the work is, who will do it, when and where it will happen, and any conditions the mall attaches.

Illustration of a request moving through approval steps
In this article (8 sections)
  1. What Is a Mall Work Permit?
  2. Common Types of Tenant Requests
  3. What a Work Permit Request Should Include
  4. How a Typical Approval Process Works
  5. Common Problems with Paper and Email Permits
  6. Managing Tenant Permits with LazyMonkey
  7. Conclusion
  8. Frequently Asked Questions

Every week, shops in a mall need work done. A tenant wants a shelf repaired, a new store needs a full fit-out, a supplier is bringing in stock after hours, or a contractor is coming to fix the air conditioning. Each of these brings people, tools and materials into the mall, and the mall needs to know about them before they arrive.

A clear work permit process tells tenants how to ask, tells each mall team what to check, and leaves a record of who approved what. This guide covers the request types, what a request should include and how a typical approval runs.

What Is a Mall Work Permit?

It is the general approval for tenant work. Higher-risk jobs carry an extra, specific permit on top: welding, cutting and grinding need a hot work permit with its own fire precautions and fire watch.

Common Types of Tenant Requests

  • Repair and maintenance work inside a store
  • Material inward and outward movement
  • Contractor and vendor entry
  • Fit-out and renovation work
  • Store handover and takeover
  • After-hours work

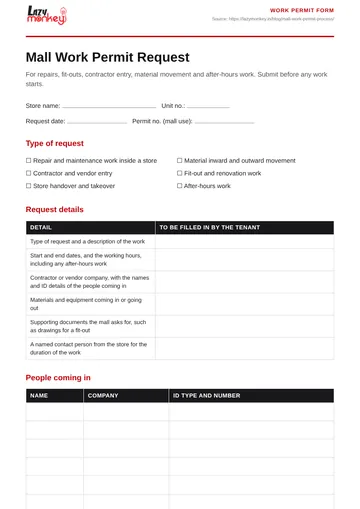

What a Work Permit Request Should Include

A complete request saves a round of back-and-forth. Ask tenants for:

  • Store name and unit number
  • Type of request and a description of the work
  • Start and end dates, and the working hours, including any after-hours work
  • Contractor or vendor company, with the names and ID details of the people coming in
  • Materials and equipment coming in or going out
  • Supporting documents the mall asks for, such as drawings for a fit-out
  • A named contact person from the store for the duration of the work

How a Typical Approval Process Works

  1. The tenant raises a request with the details above.
  2. Mall operations reviews it and checks the request is complete.
  3. The facility or engineering team reviews the work, especially anything touching electrical, plumbing, air conditioning or the structure of the store.
  4. Security is told who is expected and when, so contractors are not stopped, or let in, without anyone knowing why.
  5. The tenant receives the outcome, with any conditions, before the work starts.
  6. The work is completed and closed, and the request is kept as a record.

Different request types often need different steps. A small repair may need one approval, while a fit-out may need several departments to sign off. For any work near exits, alarms or extinguishers, run the relevant items on your fire safety checklist before and after the job.

What Each Department Checks

  • Operations: the request is complete, dates do not clash with mall events or peak trading, and the material route avoids busy common areas.
  • Engineering and MEP: any connection to, or shutdown of, electrical, plumbing, drainage or air conditioning, fit-out drawings, and who will isolate and restore services.
  • Security: the worker list and IDs, loading bay and vehicle bookings, and gate passes for material going out.
  • Fire and safety: whether detectors, sprinklers, exits or extinguishers are affected, who will restore anything covered or isolated, and that escape routes stay clear.

Conditions Commonly Attached to an Approval

  • Timings: noisy, dusty or smelly work only before opening or after closing.
  • Barricading: the work area screened from shoppers, with signage.
  • Debris removal: waste bagged and taken out through the service corridor at agreed times.
  • Insurance and indemnity: the contractor's insurance or a signed indemnity, where the lease or mall rules require it.
  • Contractor ID: passes worn at all times, and only named workers allowed in.

On-Site Checks and Closure

During the work, operations or security should visit at least once a shift to check that the people present match the permit and the conditions are being followed. If not, stop the work and note it on the permit.

At closure, a mall representative walks the area with the store contact: debris removed, common areas clean, isolated services restored and tested, no damage to shared finishes. Only then is the permit closed. For fit-outs and handovers, record the unit's condition at handover.

Emergency and After-Hours Work

A burst pipe or a jammed shutter cannot wait for the normal route. Agree an emergency route in advance: the duty manager approves by phone, security logs the contractor in, and the full permit is raised the next working day. Define which situations qualify, so routine jobs cannot skip the queue.

Planned after-hours work should name the hours, the entry point, the mall staff on duty, and how lighting, lifts and air conditioning will be handled while the mall is closed.

Common Problems with Paper and Email Permits

In many malls, tenant requests arrive by email, phone, WhatsApp or paper form. Approvals stall in someone's inbox, security finds out about a contractor when they turn up at the gate, and when something goes wrong there is no record of who approved what. Moving every request into one system with a defined approval route fixes most of these problems.

Common Delays and How to Avoid Them

  • Incomplete requests: publish the required details and documents, and only start review once the request is complete.
  • Late submissions: set a notice period for each request type, shorter for repairs and longer for fit-outs, and share it at tenant onboarding.
  • Approver away: name a deputy for each department.
  • Changes after approval: treat new dates, contractors or scope as an amendment that goes back to the affected teams.

Record-Keeping

Keep each permit with its approvals, conditions, site-check notes and closure sign-off together, for as long as your lease terms, insurer or internal policy require. The record should show quickly who did the work, who approved it, under what conditions, and whether it was closed properly. That history matters if a job later leads to an incident report.

Managing Tenant Permits with LazyMonkey

LazyMonkey Tenant Permits & Approvals gives every request one approval trail:

  • Design each request form and approval route yourself, with no coding, and send requests down different paths by type of work or area.
  • Require sign-off from more than one department at a single step, and approve from a phone.
  • Notify the tenant and each approver by WhatsApp, SMS, email or mobile push, with reminders if a request waits.
  • Keep a time-stamped audit trail of every submission, approval and comment, with linked contractors and visitors.

Conclusion

A good work permit process protects the mall, its shoppers and its tenants. Agree the request types you accept, ask for the right details up front, route each request through the teams that need to check it, and keep a record of every decision.

Frequently Asked Questions

What is a work permit in a mall?

It is the written approval a tenant gets from mall management before carrying out work, bringing in contractors or moving materials, setting out what the work is, who will do it, when and where.

Who approves tenant work permits in a mall?

It depends on the mall and the type of request. A common route is mall operations, then the facility team, then security, with more departments signing off for larger jobs such as fit-outs.

What details should a contractor provide?

The company name, the names and ID details of the people coming in, the dates and hours of work, the materials and equipment they will bring, and any documents the mall asks for.

Can tenants track the status of their requests?

With a digital permit system, yes. In LazyMonkey, tenants see the status of every request they have raised and are notified at each step.
